Acute Dependency Wards - Lincoln Hospital

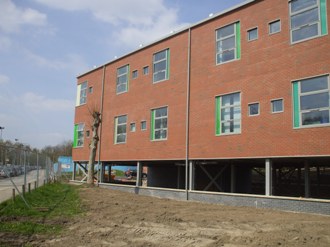

The new additional acute inpatient accommodation was successfully completed on 31st March 2010, comprising of piled foundations, heavily reinforced ground beams and steel supporting structure to provide foundations for the new 56 bedroomed bay wards.

The works commenced on 28th September 2009, with the substructure and demolition of existing 4 bedroomed ward and play room.

The substructure was completed on programme in readiness for the delivery of PKL Healthcare Modular units on 14th December 2009. The 56 units arrived from the factory to be erected over 8 days.  The new services and internal installations were then carried out for a completion date of 1st March 2010.

The Gelder Group carried out further additional works such as new playroom construction to Ruston Ward along with further external works.

The 6 million project was completed in 24 weeks. The new accommodation was formally occupied on 9th April 2010.
